Villa Renovation Timeline Dubai: What To Expect
A villa renovation timeline in Dubai usually runs 8 to 20 weeks depending on scope. Cosmetic refreshes are faster, full gut renovations and extensions take longer, and the phases below show where the weeks go.
Why work with Lacasa Line Decoration Design And Fitout LLC
- Full villa renovations from AED 100,000
- Design, approvals and turnkey execution in one team
- Google rating 5 from 2 client reviews
- Serving Dubai and Sharjah villa projects
- Direct WhatsApp and phone line at +971588672244
- Specialist villa renovation and fit-out contractor
How long does a villa renovation take in Dubai?
Most villa renovations in Dubai take 8 to 20 weeks. The exact villa renovation duration Dubai depends on whether you are doing a cosmetic refresh, a full gut renovation or a structural extension.
| Scope | Typical duration | What it includes |
|---|---|---|
| Cosmetic refresh | 4 to 8 weeks | repainting, flooring, lighting, new doors and wardrobe touches |
| Full gut renovation | 10 to 16 weeks | strip to structure, new MEP, bathrooms, kitchen, partitions and finishes |
| Extension or structural change | 16 to 24 weeks | DET and Trakhees approvals, footings, blockwork, roofing and full fit-out |
A full villa renovation from AED 100,000 usually falls in the 10 to 16 week range when no major extension is added. A villa in Dubai with easy site access often moves faster than a villa in Sharjah with tighter street access and delivery constraints. turnkey villa renovation services cover the full scope so you are not coordinating six separate subcontractors.
Villa renovation phases Dubai
A typical villa renovation schedule Dubai moves through six phases. The sequence below assumes a full renovation, not a light refresh.
- Initial survey and design: 1 to 2 weeks for measured survey, space planning, materials and drawings.
- DET and Trakhees approvals: 2 to 4 weeks, often running in parallel with design for extensions or structural work.

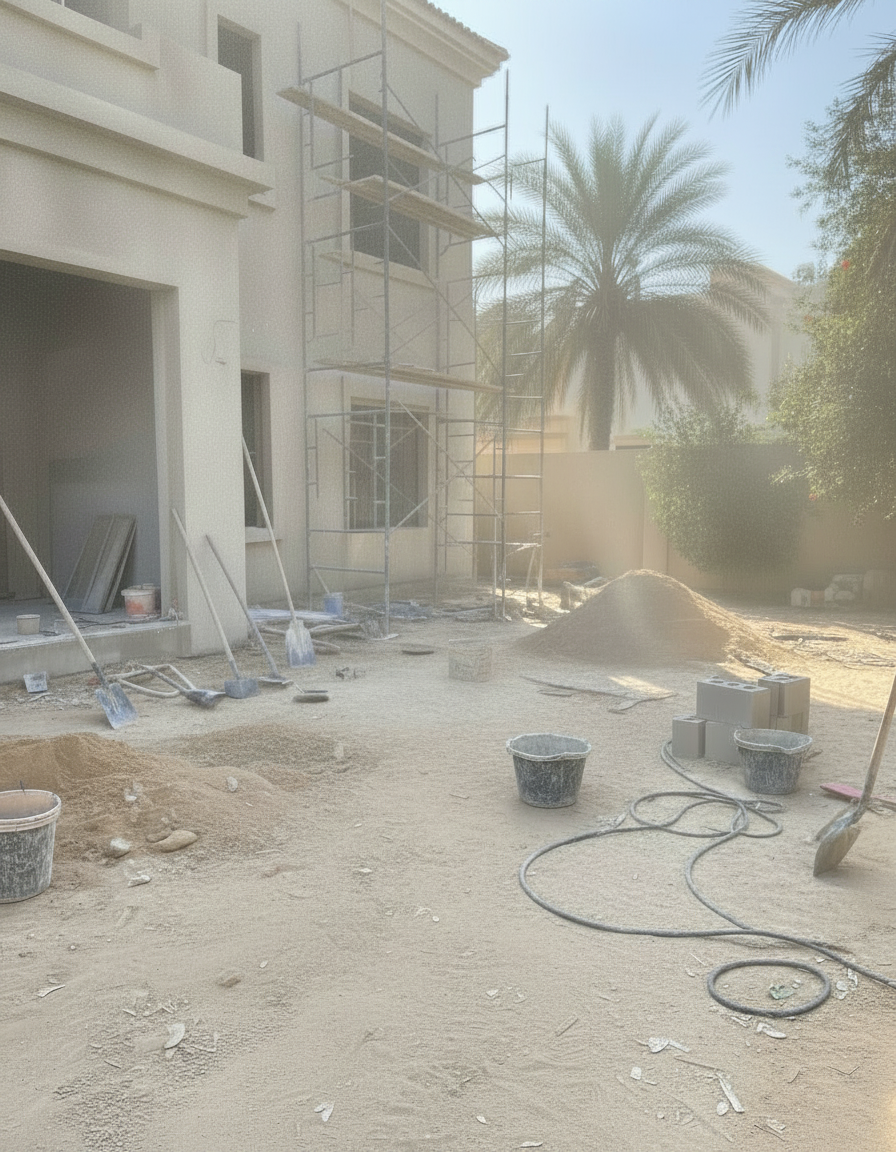

- Structural and extension works: 3 to 6 weeks if walls are moving or floor area is being added.
- MEP first fix: 2 to 3 weeks for plumbing, electrical, air conditioning and data.
- Finishes and joinery: 4 to 8 weeks for tiling, painting, kitchen installation, wardrobes and flooring.
- Snagging and handover: 1 to 2 weeks for defects, cleaning and final inspection.
Structural and extension works are where a villa renovation schedule Dubai can shift around approvals and site access.
Davranbek, 5/5:
The wardrobe cabinets fit well. Looks clean and straight. We are happy with the finish.
What slows a villa renovation timeline in Dubai
Three things commonly slow a villa renovation timeline in Dubai. Knowing them helps you avoid surprise delays.
- Approvals. DET and Trakhees submissions can take two to four weeks. Community NOCs add time if the villa is in a gated community.
- Material lead times. Tiles, kitchens, stone tops and bespoke joinery can take three to six weeks from order.
- Change orders. Moving a wall or changing sanitary ware after MEP first fix can add one to three weeks.
Older villas often hide unexpected pipe or slab conditions. Allow one week of buffer in your villa renovation schedule Dubai.
Madani, 5/5:
Great workmanship and attention to detail Absolutely loved working with meershad who was always helpful and willing to find the best interest of client
How to keep your villa renovation schedule Dubai on track
A realistic programme is only useful if decisions are made on time. The fastest projects lock finishes early and avoid changes after first fix.
- Select tiles, stone, sanitary ware and kitchen appliances before the approval phase ends.
- Confirm room layouts and electrical positions during design, not on site.
- Use one turnkey team for design, approvals and execution so delays are not passed between contractors.
A completed space is the result of a controlled villa renovation schedule Dubai, with finishes installed in sequence to protect the handover date.
What you can budget for a full villa renovation
A full villa renovation in Dubai starts from AED 100,000 with the scope covered by Lacasa Line Decoration Design And Fitout LLC. That budget typically includes design work, approvals management, demolition, MEP upgrades, joinery and final finishes for a standard villa, but not large structural extensions.
For a cosmetic refresh in Dubai or Sharjah, lower budgets are common. Extensions can push well above this baseline once structural works and authority approvals are added. Review completed villa renovation projects to see how finishes look. Before you commit to a date, book a free villa renovation consultation and get a phased programme for your villa.
Frequently asked questions
How long does a full villa renovation take in Dubai?
A full villa renovation usually takes 10 to 16 weeks from strip out to handover. If you are adding an extension or changing the structure, allow 16 to 24 weeks because DET and Trakhees approvals and structural works add time. Choosing a turnkey contractor keeps the villa renovation duration Dubai more predictable.
How much does it cost to renovate a villa in Dubai?
A full villa renovation with Lacasa Line Decoration Design And Fitout LLC starts from AED 100,000. Cosmetic refreshes can be lower, while extensions and high spec joinery push costs higher. The final figure depends on villa size, MEP condition and finish level.
Do I need municipality approval for a villa renovation in Dubai?
Yes, most villa renovations in Dubai need approvals. The exact requirements depend on the community and the scope. Structural changes, extensions and some MEP upgrades need DET or Trakhees approval, and gated communities often require an NOC. Your contractor should manage this as part of the timeline.
Can I live in my villa during a renovation?
It is possible for a cosmetic refresh but difficult for a full gut renovation. Full strip out, MEP replacement and wet trades make the villa hard to live in. Most clients move out for the main works and return after snagging.
What is included in a turnkey villa renovation?
A turnkey villa renovation includes design, approvals, demolition, MEP, structural work if needed, finishes, joinery and snagging. You deal with one contractor rather than separate designers and subcontractors. This helps keep the villa renovation schedule Dubai aligned from start to handover.
